Fall Line Trail – Lakeside Community Trail Phase 1, 2, and 3

Project Status: Advertised for Construction

Estimated Cost: See below
Start Date: 4th Quarter, 2026
Estimated End Date: 2028

Magisterial District:   Fairfield

Henrico County is proposing the construction of a new trail in the Lakeside community.  The trail will be a 12-foot-wide multi-use trail that is approximately 2 miles in length and will include several pedestrian bridges over Upham Brook tributary. The trail is part of the Fall Line Trail that runs from Ashland to Petersburg. The Lakeside trail will provide a connection from Spring Park to Hilliard Road in the Lakeside community.  The County has been awarded Transportation Alternatives grant funding to construct this trail.

The trail is being designed in three phases and they are separated as follows:

  • Lakeside Phase 1 – Spring Park to Dumbarton Rd – 3,200 linear feet
    • Estimated Cost: $2.8 million
    • PM Name: Ryan Levering
    • PM Phone#: 804-501-4244
    • PM E-Mail: [email protected]
  • Lakeside Phase 2 – Dumbarton Rd to Lakeside Recreation Area – 2,640 linear feet
    • Estimated Cost: $4.5 million
    • PM Name: Sarah Briggs
    • PM Phone#: 804-501-4616
    • PM E-Mail: [email protected]
  • Lakeside Phase 3 – Lakeside Recreation Area to Hilliard Road – 3,400 linear feet
    • Estimated Cost: $4.5 million
    • PM Name: Sarah Briggs
    • PM Phone#: 804-501-4616
    • PM E-Mail: [email protected]

Estimated Schedule

Activity Phase 1 Phase 2 Phase 3

Design

Complete

Complete

Complete

Right-of-way Acquisition

Complete

Complete

Complete

Utility relocation

Complete

Complete

Complete

Advertisement for Construction

Advertised 6/30/26 as Lakeside Community Trail Phase 1. Closes 7/30/26.

Advertised 6/30/26 as Fall Line Trail Southern Sections. Closes 8/13/26.

Advertised 6/30/26 as Fall Line Trail Southern Sections. Closes 8/13/26.

Construction

4th Quarter, 2026

4th Quarter, 2026

4th Quarter, 2026

Project Completion

2028

2028

2028

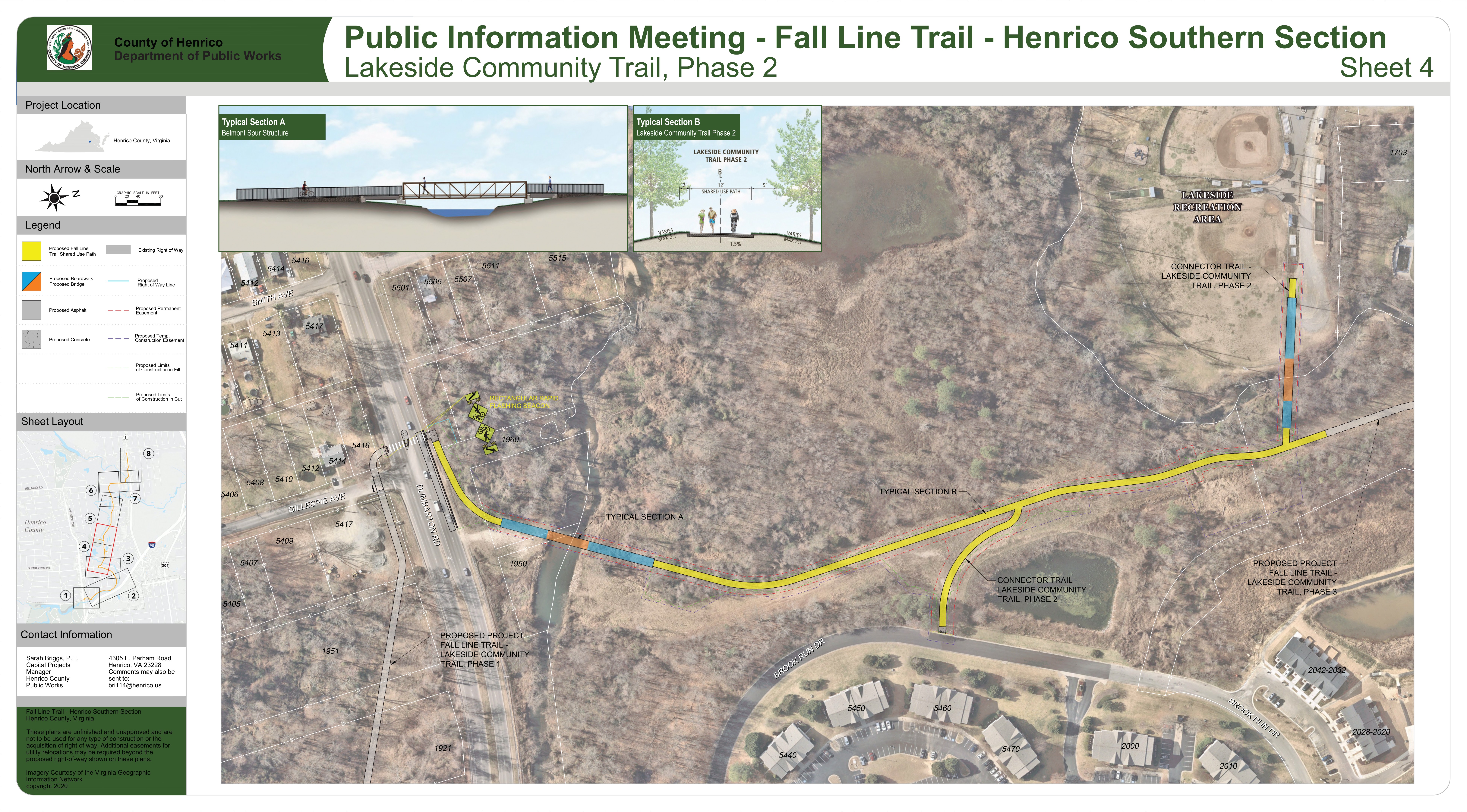

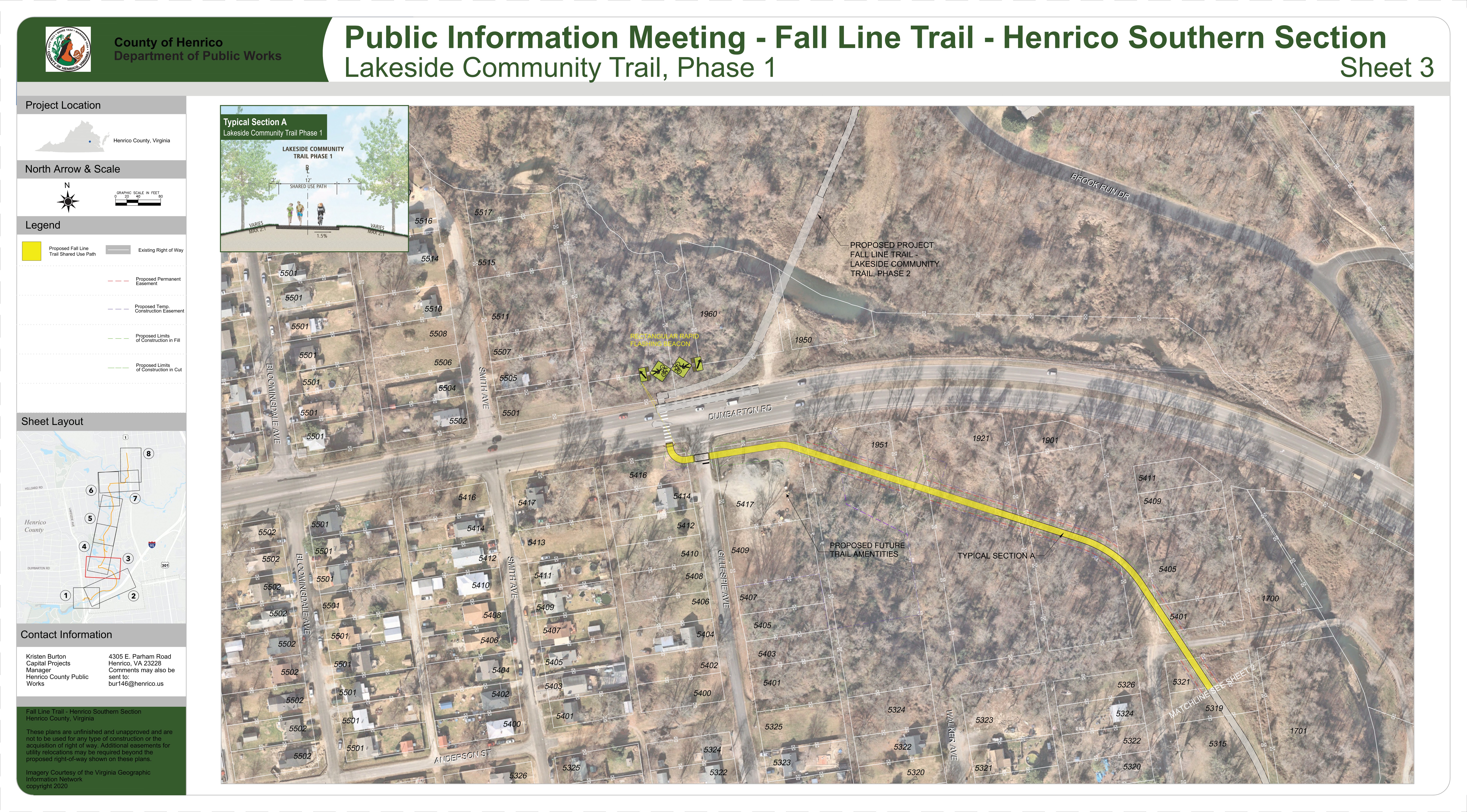

Lakeside Community Trail map

Progress to Date

  • On Tuesday, May 16, 2023, the Henrico County Department of Public Works held a public information meeting from 5:00pm to 6:30pm at Lewis Ginter Botanical Gardens. Materials from the meeting can be found in the Documents section below.
  • On Thursday, September 19, 2019 the Henrico County Department of Public Works held a Citizen Information Meeting from 6 p.m. to 7 p.m. to discuss this project.
